How Long Does the Hat Manufacturing Process Take from Design to Delivery?

How Long Does the Hat Manufacturing Process Take from Design to Delivery?

Many brands expect delivery in weeks—but don’t realize the process involves sampling, approvals, production, and shipping delays1.

Hat manufacturing typically takes 4–8 weeks from design to delivery, depending on sampling speed2, customization complexity3, and chosen shipping method. Rush services may reduce timelines by 1–2 weeks.

custom hat production timeline chart

When I plan a campaign, I build timelines backwards from the delivery date—so there’s room for design revisions4 and factory delays.

What Are the Typical Phases in Hat Manufacturing?

Every custom hat order goes through set stages—and skipping one usually leads to mistakes or rework.

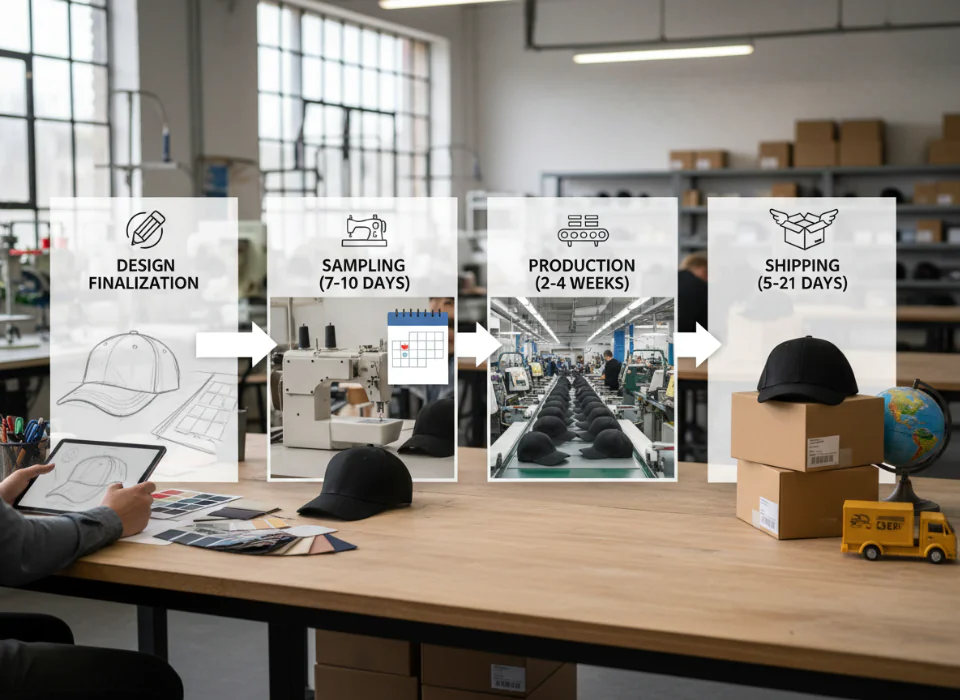

Phases include design finalization, sampling (7–10 days), production (2–4 weeks), and shipping (5–21 days based on method).

custom cap production workflow

My Timeline from Design to Delivery

The first time I ordered custom hats, I underestimated how many steps were involved. I thought once I confirmed the design, production would start. But first, I had to approve a sample—and that took 10 days. Then came revisions. Then came Chinese New Year.

Now I break the process into four predictable parts:

Phase Time Estimate Key Milestones
Design + Quoting 2–5 days Finalize mockups, tech packs
Sampling 7–10 days Receive and approve physical sample
Bulk Production 14–30 days Based on style complexity and order size
Shipping 5–35 days DHL (5–7), Sea Freight (20–35)

When working with Anthea, I usually complete small batches in 5 weeks via express shipping. That includes sampling, revisions, production, and delivery.

What Factors Affect the Overall Production Timeline?

No two orders move at the same speed. Your choices shape the entire schedule.

Lead time depends on materials, number of styles, embroidery complexity5, factory workload6, and how fast you approve samples.

factors that affect manufacturing speed

7 Things That Add Days to Production

I’ve had orders delayed because I requested glow-in-the-dark thread. Another delay happened because I changed the panel layout after the sample was made. Every customization adds time.

These are the biggest time factors I watch out for:

Factor Impact on Time
Custom fabric sourcing Adds 5–10 days
Complex embroidery (6+ colors) Adds 3–5 days
Multiple styles in one order Adds 7+ days
Slow sample approvals Adds unlimited delays
Factory peak season Adds 7–15 days
National holidays (e.g., CNY) Adds 10–20 days
Last-minute design changes Resets sample/production timeline7

To avoid delays, I keep designs simple when timelines are tight—and I always check the factory calendar.

Are Rush Orders Possible for Custom Hat Manufacturing?

Yes, but not every factory offers them—and not every product is rush-friendly.

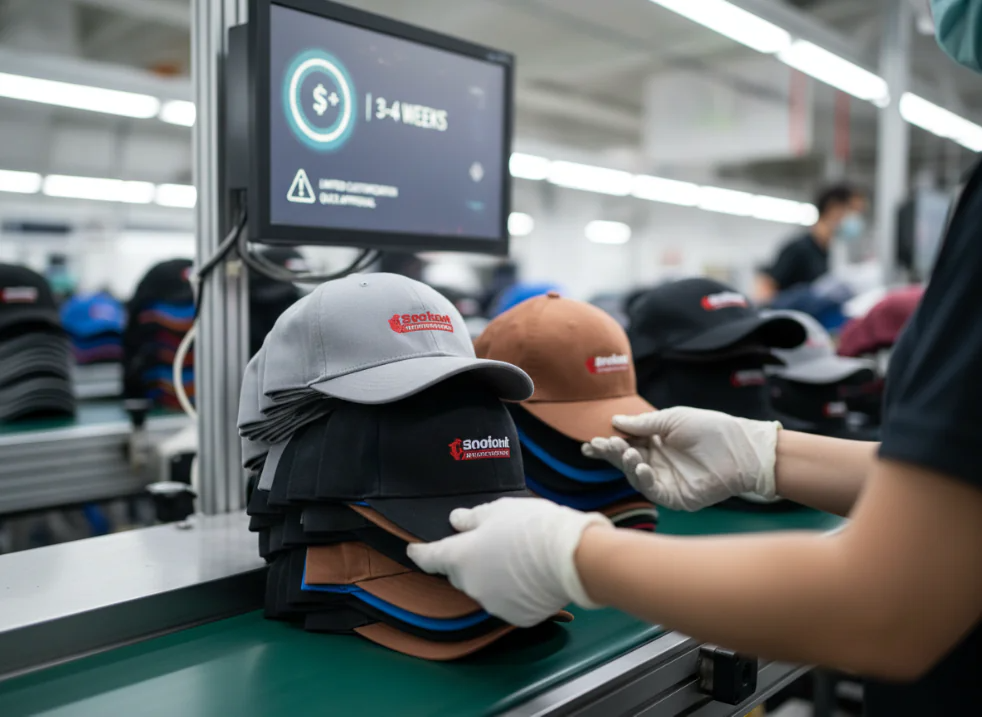

Rush production may cut timelines to 3–4 weeks, but typically costs more and limits customization options. Sampling must be approved quickly.

fast turnaround custom hats

How I Handle Rush Orders Without Sacrificing Quality

I’ve done multiple rush projects—event launches, influencer drops, urgent restocks. The key is alignment. I tell the factory upfront, “This is a rush job,” and I limit the customization.

Here’s my checklist for rush-friendly orders:

  • Use in-stock fabric and closures
  • Choose embroidery over print (faster)
  • Finalize design with zero changes
  • Approve samples within 24 hours
  • Accept slightly higher unit costs
  • Choose DHL over sea freight
Step Standard Time Rush Order Time
Sampling 7–10 days 4–5 days
Production 14–30 days 7–14 days
Shipping (DHL) 5–7 days 3–5 days

Rush orders are doable, but only if you commit fast and stay organized.

How Do Shipping Methods Impact Delivery Time?

Production is only part of the timeline. Shipping can make or break your deadline.

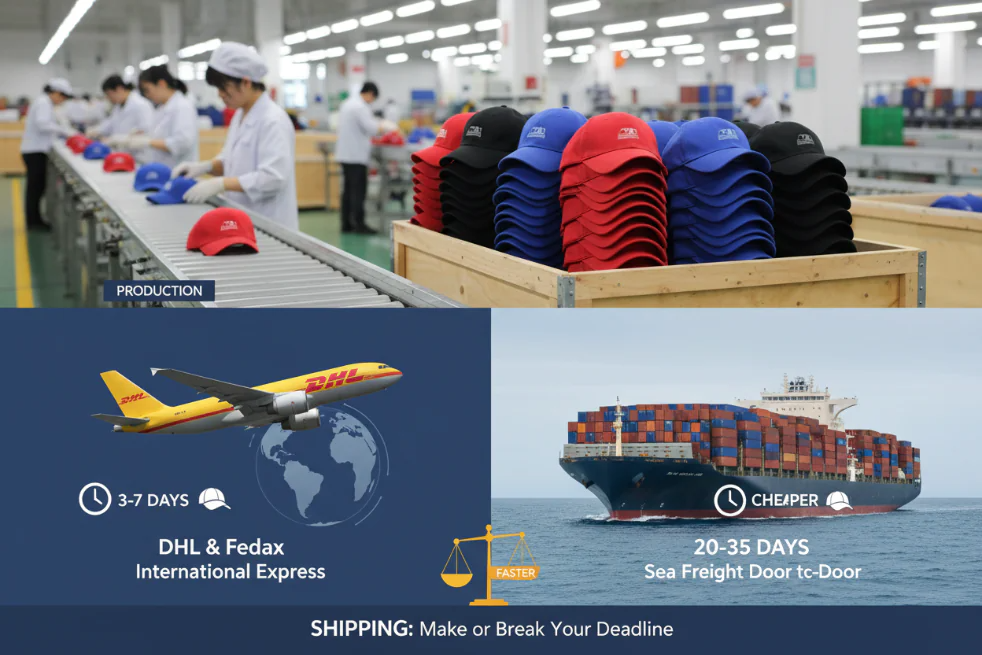

DHL and FedEx take 3–7 days for international express. Sea freight is cheaper but slower—often 20–35 days door-to-door.

delivery methods chart

How I Choose the Right Shipping Based on My Deadline

I’ve used all three major options—DHL, FedEx, and sea freight. When time is tight, I always go with DHL. It costs more, but peace of mind is worth it.

Here’s how I decide:

Shipping Method Speed (Days) Best For Notes
DHL/FedEx/UPS 3–7 Launches, limited drops More expensive per carton
Sea Freight 20–35 High-volume inventory, restocks Plan ahead, slower customs
Air Freight 7–12 Balance of cost and speed Slightly slower than express

Also, I make sure packaging is export-ready. If customs holds a shipment because of bad labeling, even DHL can’t save you.

Conclusion

Knowing your full timeline helps you plan smarter, avoid surprises, and hit deadlines with confidence.



  1. Identifying causes of shipping delays can help you mitigate risks in your supply chain.

  2. Learn how sampling speed impacts the overall production process and delivery times.

  3. Explore how customization complexity can influence production timelines and costs.

  4. Understanding the importance of design revisions can prevent costly mistakes in production.

  5. Understanding embroidery complexity can help you make informed decisions about your designs.

  6. Explore how factory workload can affect your order’s delivery schedule.

  7. Get insights into the production timeline to better manage your expectations.
